4.1 Typical System Topology

The reference topology for a critical data transmission security system organizes network zones in a layered defense model, where each boundary crossing requires explicit authorization and cryptographic verification. The design starts from the Internet edge and works inward through progressively more trusted zones, with the PKI/KMS and SIEM infrastructure positioned as shared services that support all zones without being directly reachable from untrusted networks.

The topology is designed for a medium-to-large enterprise with Internet-facing APIs, internal microservices, site-to-site replication, and privileged admin access requirements. Smaller deployments may consolidate the DMZ and App Zone onto fewer physical devices, while larger environments may replicate each zone across multiple availability zones or data centers for resilience.

Typical System Topology Diagram

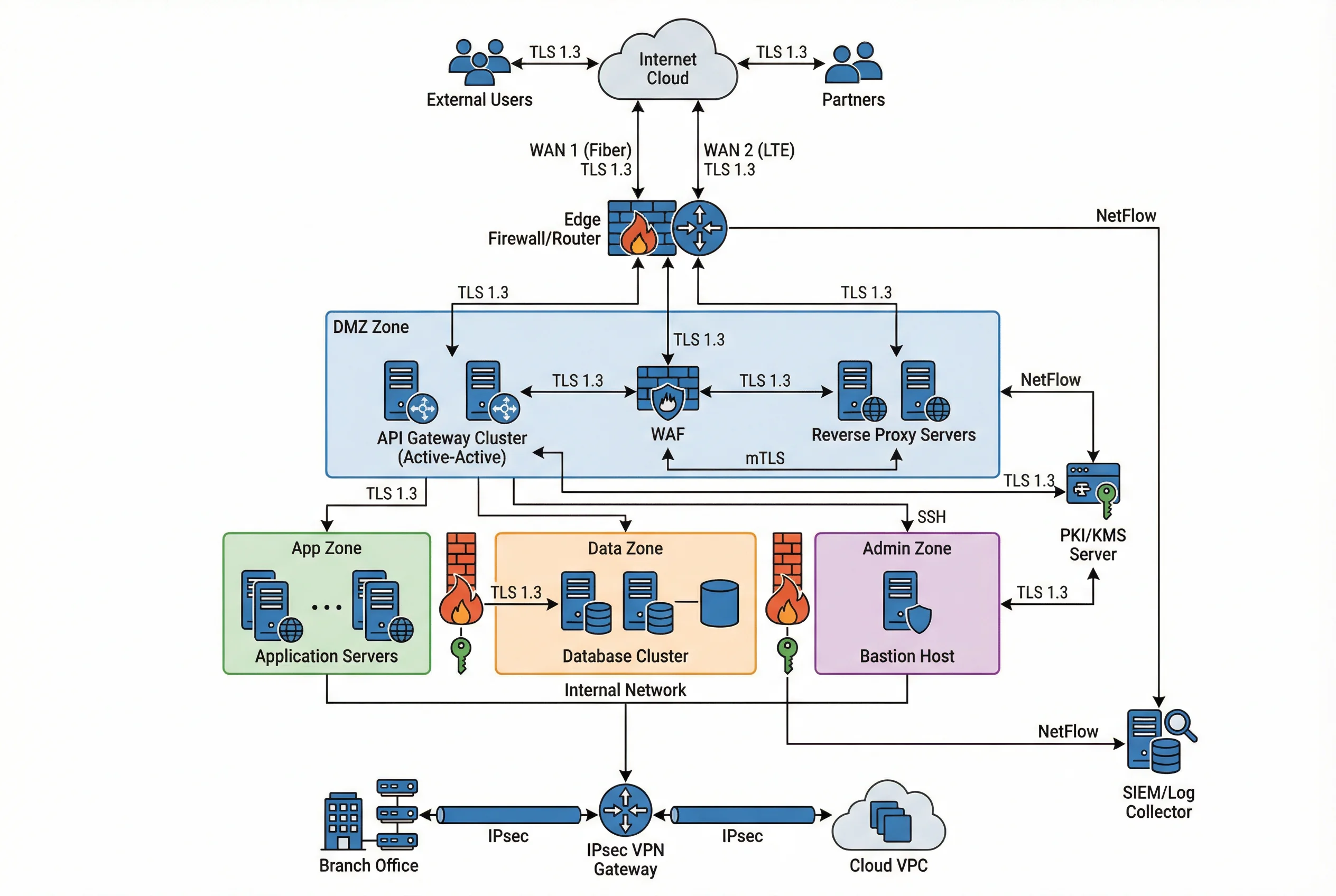

Figure 4.1: Typical System Topology — layered zone architecture from Internet edge through DMZ (API Gateway, WAF, Reverse Proxy), Internal zones (App, Data, Admin), to IPsec VPN gateway for branch and cloud connectivity. PKI/KMS and SIEM shown as shared infrastructure services.

Zone Definitions and Trust Levels

ZoneTrust LevelPrimary ComponentsInbound SourcesOutbound TargetsKey Controls
InternetUntrustedExternal users, partners, attackersN/AEdge Firewall onlyNone (hostile)
EdgeSemi-trustedEdge Firewall, WAN routersInternet (filtered)DMZ onlyStateful firewall, DDoS mitigation
DMZLow-trustAPI Gateway, WAF, Reverse ProxyEdgeApp Zone (mTLS)TLS termination, auth enforcement, WAF rules
App ZoneMedium-trustApplication servers, microservicesDMZ (mTLS)Data Zone (mTLS)Service mesh mTLS, network policy
Data ZoneHigh-trustDatabase cluster, object storageApp Zone onlyReplication (IPsec)Encryption at rest, strict ACL
Admin ZonePrivilegedSSH Bastion, management serversAdmin workstations (MFA)All zones (audited)MFA, session recording, PAM
VPN/WANControlledIPsec gatewaysBranch, Cloud VPCApp/Data ZoneIKEv2, AES-256-GCM, PFS
Shared ServicesInfrastructurePKI/KMS, SIEM, NTPAll zones (pull)All zones (push logs)Isolated management network

4.2 Device Interconnection and Wiring

Physical and logical device interconnection follows a structured cabling plan that separates production traffic, management traffic, and replication traffic onto distinct VLANs and physical paths where feasible. Color-coded cabling conventions — orange for WAN/production, blue for management, green for replication — reduce miscabling risk during installation and maintenance. All rack-mounted appliances are connected to a dedicated out-of-band (OOB) management switch that provides console access and IPMI/iDRAC connectivity independent of the production network.

Data Center Equipment Rack Wiring Diagram

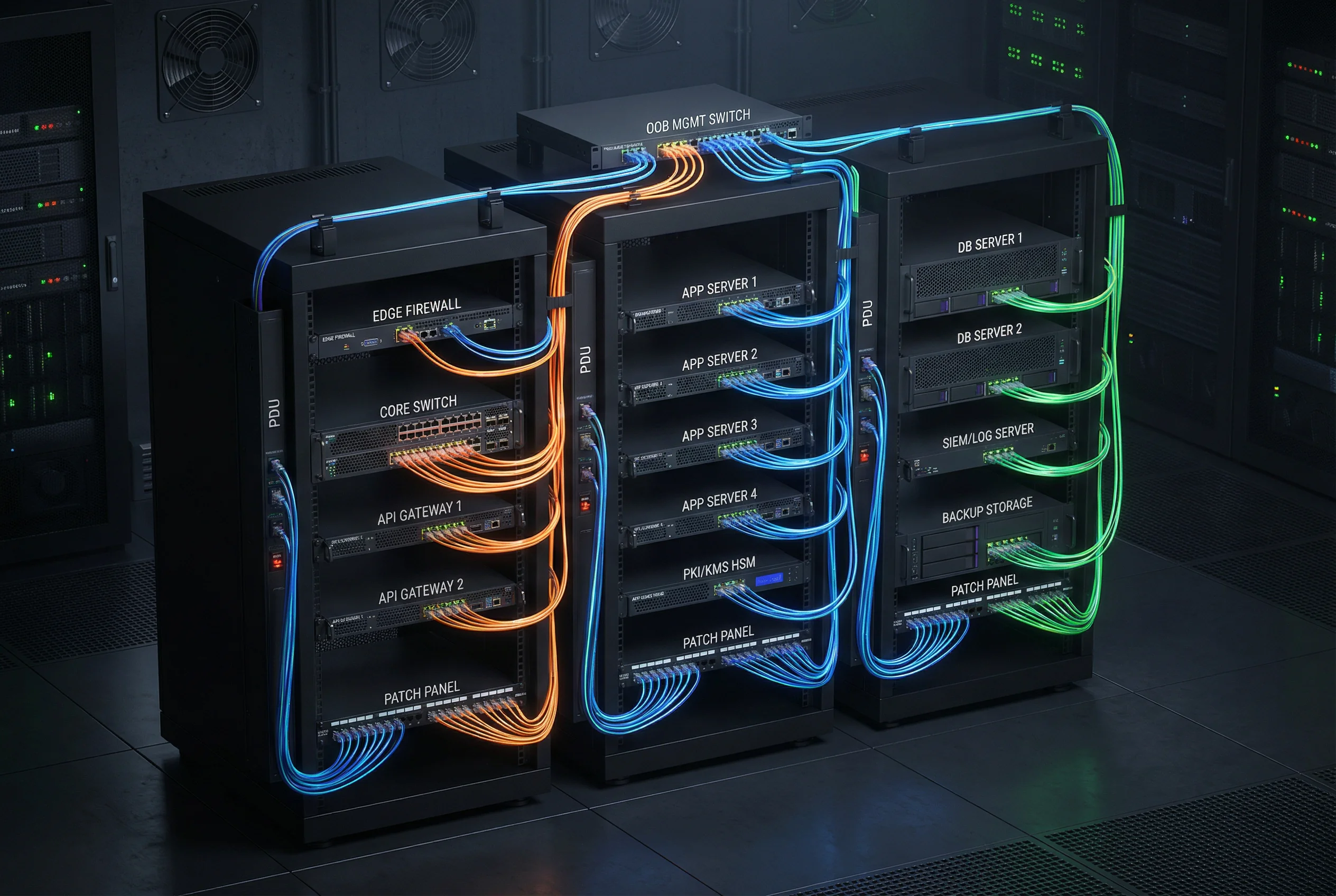

Figure 4.2: Data Center Equipment Rack Wiring — three-rack layout showing Edge Firewall, Core Switch, API Gateways (Rack 1), Application Servers and PKI/HSM (Rack 2), Database Servers, SIEM, and Backup Storage (Rack 3). Color-coded cabling: orange (production), blue (management), green (replication).

Physical Connectivity Matrix

Source DeviceDestination DeviceInterface TypeVLAN / NetworkProtocolRedundancy
Edge FirewallCore Switch10G SFP+VLAN 10 (DMZ)802.1Q trunkLAG (2 links)
Core SwitchAPI Gateway 1/210G SFP+VLAN 10 (DMZ)802.1Q accessActive-Active
API GatewayApp Servers10G SFP+VLAN 20 (App)mTLS/HTTPSLoad balanced
App ServersDB Cluster10G SFP+VLAN 30 (Data)mTLS/TLS 1.3Primary/Replica
PKI/HSMAll devices1G RJ45VLAN 40 (Mgmt)HTTPS/ACMEHA pair
All devicesSIEM/Log Server1G RJ45VLAN 40 (Mgmt)Syslog/TLSRedundant path
All devicesOOB Mgmt Switch1G RJ45 (IPMI)VLAN 50 (OOB)IPMI/iDRACIndependent path
DB ClusterBackup Storage10G SFP+VLAN 60 (Repl)Encrypted replicationDedicated VLAN

4.3 High Availability and Redundancy Design

High availability is achieved through active-active or active-standby redundancy at every critical component, combined with health-check-based failover and automated certificate renewal to prevent availability gaps from cryptographic expiry. The design targets a Recovery Time Objective (RTO) of 30 seconds for Tier-0 flows and 5 minutes for standard flows, with a Recovery Point Objective (RPO) of zero for stateful gateway configurations synchronized via HA protocols.

ComponentHA ModelFailover TriggerFailover TimeState SyncRTO Target
API GatewayActive-Active (LB)Health check failure≤ 5 secSession persistence via LB≤ 5 sec
Edge FirewallActive-StandbyLink/heartbeat failure≤ 30 secConnection table sync≤ 30 sec
IPsec GatewayActive-StandbyTunnel/IKE failure≤ 30 secIKE SA sync≤ 30 sec
PKI/CAPrimary + Offline RootManual (planned)Minutes (planned)CRL/OCSP replicationMinutes
KMS/HSMActive-Active clusterNode failure≤ 10 secKey sync via HSM protocol≤ 10 sec
SIEMPrimary + Hot StandbyProcess/disk failure≤ 5 minLog forwarding buffer≤ 5 min
WAN LinksDual diverse pathsLink down / BFD≤ 10 secBGP/static failover≤ 10 sec

4.4 Phased Deployment Plan

A phased deployment approach reduces risk by establishing foundational controls first and layering additional capabilities as operational confidence grows. Each phase has defined entry criteria, deliverables, and acceptance tests before the next phase begins. The typical delivery timeline for a medium enterprise is 8–16 weeks, depending on existing infrastructure maturity and organizational change management capacity.

PhaseDurationKey ActivitiesDeliverablesAcceptance Criteria
Phase 1: FoundationWeeks 1–3PKI/KMS deployment, NTP hardening, flow mapping, firewall baselineCA hierarchy, key policies, flow inventoryCA issues certs; NTP synchronized; flow map approved
Phase 2: TransportWeeks 4–7TLS 1.3 enforcement, mTLS for critical APIs, IPsec tunnels, SSH bastionTLS profiles, mTLS configs, IPsec SAs, bastion runbookZero TLS 1.0/1.1; mTLS handshake success ≥99.5%; tunnels stable
Phase 3: SegmentationWeeks 8–11Zone firewall rules, egress control, DNS governance, service meshFirewall matrices, egress allow-list, mesh policyDefault-deny verified; no unauthorized east-west flows
Phase 4: ObservabilityWeeks 12–14NetFlow coverage, SIEM correlation rules, alert tuning, dashboardsNetFlow coverage report, SIEM playbooks, dashboards≥90% chokepoint coverage; MTTD ≤15 min for test incidents
Phase 5: HardeningWeeks 15–16Automation testing, cert rotation drills, tabletop exercises, documentationRotation runbooks, DR test results, final acceptance packRotation success ≥99.5%; DR RTO met; acceptance pack signed
